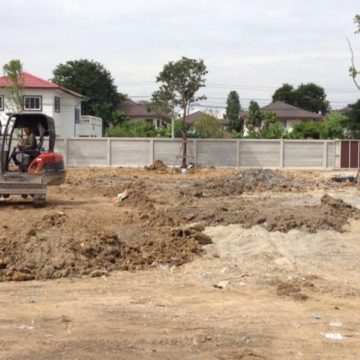

Day 658: Final Touches to New Campus

Here’s what happened during the winter break! Some final touches were made to the new campus site before the arrival of all the teachers on January 9th. A few empty plots of land were transformed into what are now playgrounds for the students. Before the installation of the playgrounds took

Read more

Day 603: Front Car Park Almost Complete

The front of school car park is now almost complete! The cement flooring is finished and the shade awning for the school bus drop off point is installed. The ramps for the car park entrance and exit to the street level have also been completed and now what remains is

Read more

Day 589: Final Stages of Architectural Construction

With just 6 weeks to go before the start of our move to the new campus, the architectural construction is in its final stages! The fence around the swimming pool is nearing completion. The hardwood rail has been installed along the fence of the swimming pool on one side and

Read more

Day 568: Work in Car Park Begins

Work has begun in the car park at the front entrance of the new campus. Steel support structures have been installed for the school bus boarding zone. A canopy shade will soon be assembled and the car park floor will receive cement pouring. After tiling was completed in the swimming

Read more

Day 554: Swimming Pool and Gym Room Near Completion

Tiling in the swimming pool has been completed. Bricks are currently being laid to construct a wall for the pool showers. The remaining work in the swimming pool includes the sand wash floor finishing and the pool fence. The plaster work in the big gym is complete along with painting.

Read more

Day 540: Fittings in Classrooms and Bathrooms In Progress

Interior work at the new campus site has started to move quickly especially in the classrooms and bathrooms. After bathroom floor tiling was completed, partition doors (orange and yellow) were installed in the different student and adult bathrooms. Sanitary ware including toilets and sinks were also fitted in the bathrooms.

Read more

Day 526: Architectural Work Continues at Rapid Pace

Work continues at a rapid pace at the new campus with the majority of construction milestones on schedule if not ahead of schedule. Flooring is complete on the second and third floor of the buildings. Window frames and glass are currently being installed in classrooms and the front building. The

Read more

Day 507: Teachers Visit New Campus

On the last day of August In-Service, the academic staff of Magic Years ventured outside the school premises to visit their future home and the site of the new Magic Years campus! In preparation for the move to the new campus (only a few short months away), the staff of

Read more

Day 490: Significant Progress Over the Summer

The summer months are nearing its end and during this time we have seen significant progress at the new campus. The masonry work is 100% complete along with the plastering of the interior walls and the first layer of paint. Much of the flooring is finished including in the large

Read more

Day 422: Masonry Work 90% Complete

The masonry work for the new campus is now 90% complete. Walking into the buildings with the walls newly constructed gives a sense of the spacious classrooms and learning spaces for the students. The construction workers have also begun the plastering work for the classroom walls and the ceiling slabs.

Read more
